When Will the Last Segment of Highway 101 Get Upgraded?

What’s the status of the last segment of the Highway 101 project, beyond Hermosillo Road—i.e. the intersection with Cabrillo Boulevard and Hot Springs Road? Is there a final design? Has the funding been identified? Is there an approved plan to widen the railroad underpass? Most importantly, what’s the projected completion date for a southbound 101 on-ramp? —D.

Fred Luna, director of project delivery and construction for Santa Barbara County Association of Governments, answered each question:

What’s the status of the last segment of the Highway 101 project, beyond Hermosillo Road? Is there a final design?

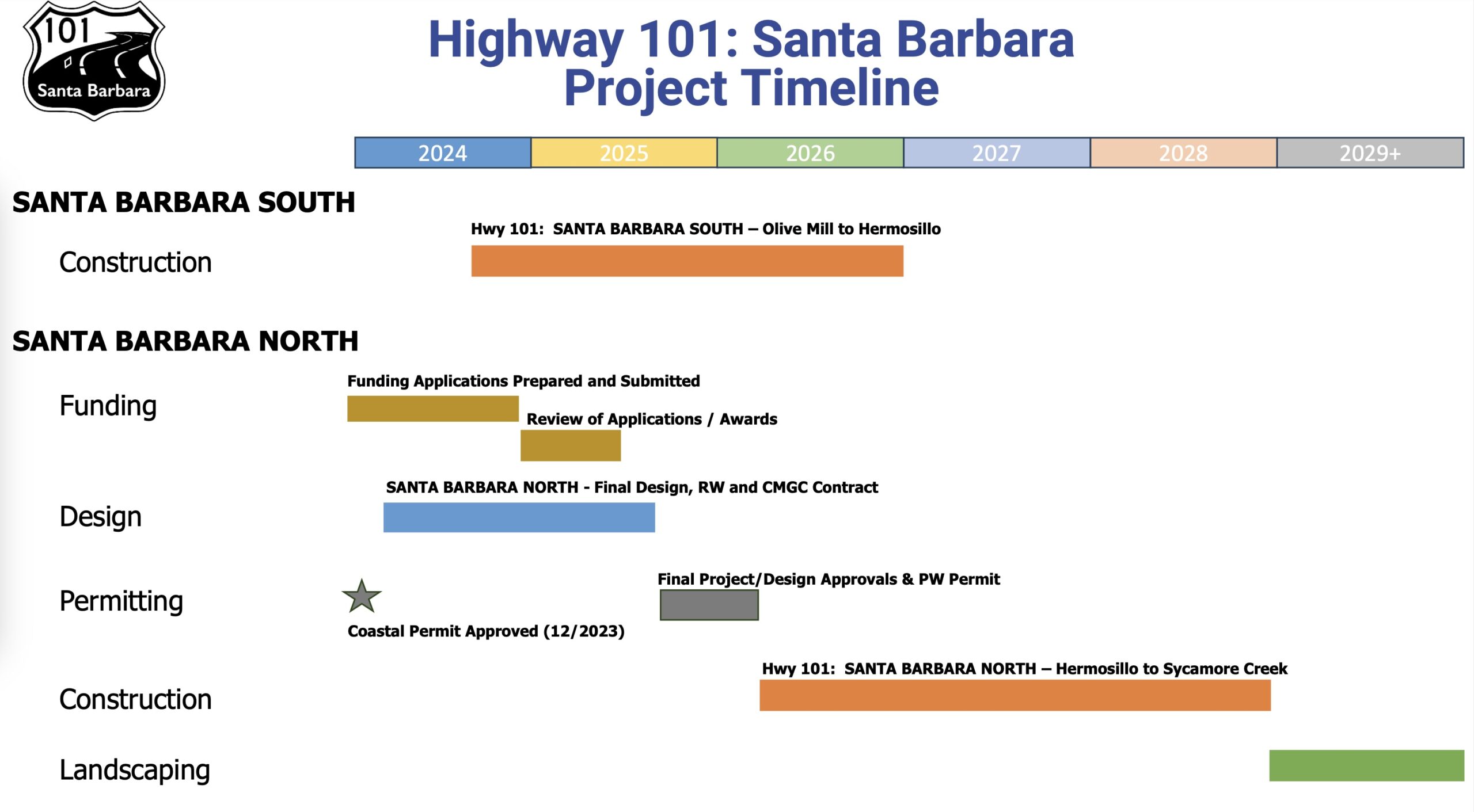

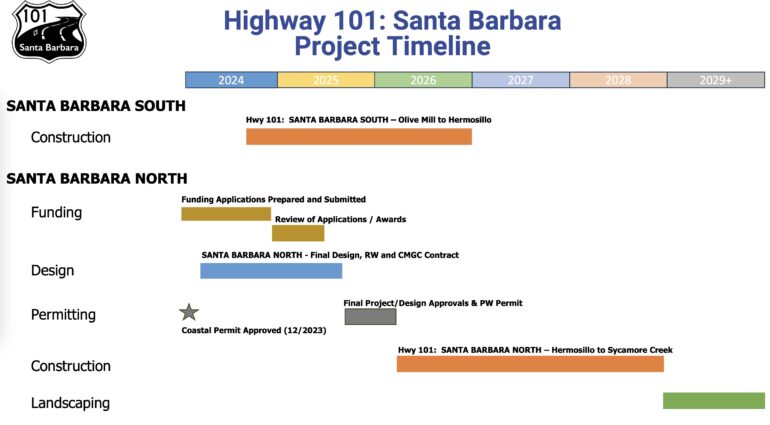

The last segment is currently in the final design phase. 95% of plans have been complete. Caltrans/SBCAG have our coastal development permit. Right of way, utility work, and railroad coordination are underway, and these efforts are anticipated to be complete by end of next year.

Has the funding been identified?

Yes, funding opportunities have been identified. The Caltrans and SBCAG team are currently in the process of submitting applications to fully fund this last segment through State Senate Bill 1 grants, along with other related improvements. Applications are due later this year, and award notifications are expected by June 2025.

Is there an approved plan to widen the railroad underpass?

I assume you are referring to the Cabrillo/Union Pacific Railroad underpass, and yes, the City of Santa Barbara has a project to replace that bridge. The replacement bridge will allow Cabrillo Boulevard to accommodate additional traffic lanes with improved roadway shoulders, multipurpose paths, and sidewalks.

Most importantly, what is the projected completion date for a southbound 101 entrance ramp?

The southbound on ramp at Cabrillo Boulevard is part of the SBCAG/Caltrans project where the interchange with 101 is reconstructed. Assuming we receive funding in June 2025, and design is complete at the end of 2025 as noted above, then construction is planned to start in spring 2026. The initial work to construct bridges and ramps, one of which will be to restore the Cabrillo southbound on ramp, will take up to two years. I would say that by summer of 2028, the Cabrillo southbound on ramp will be available.

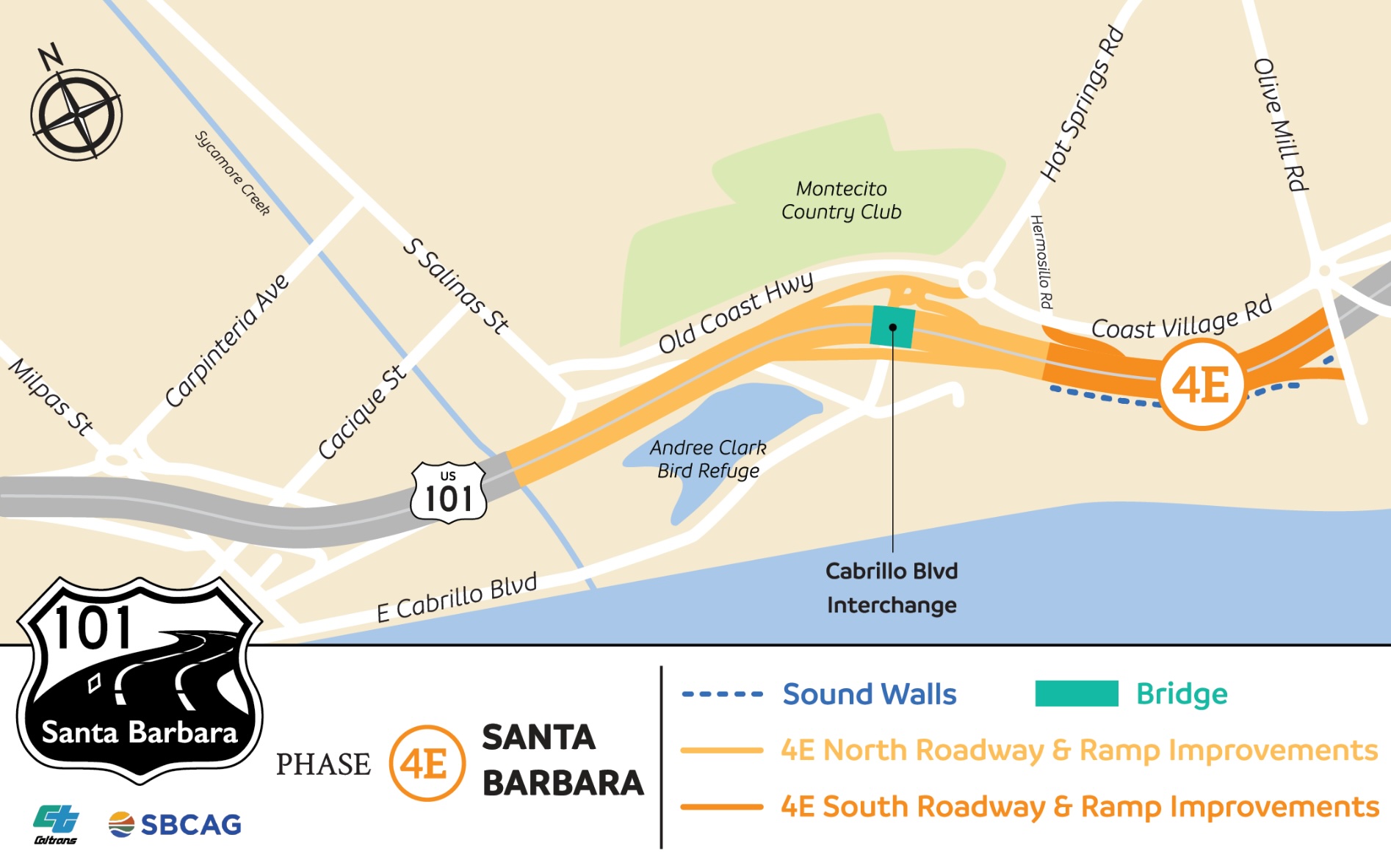

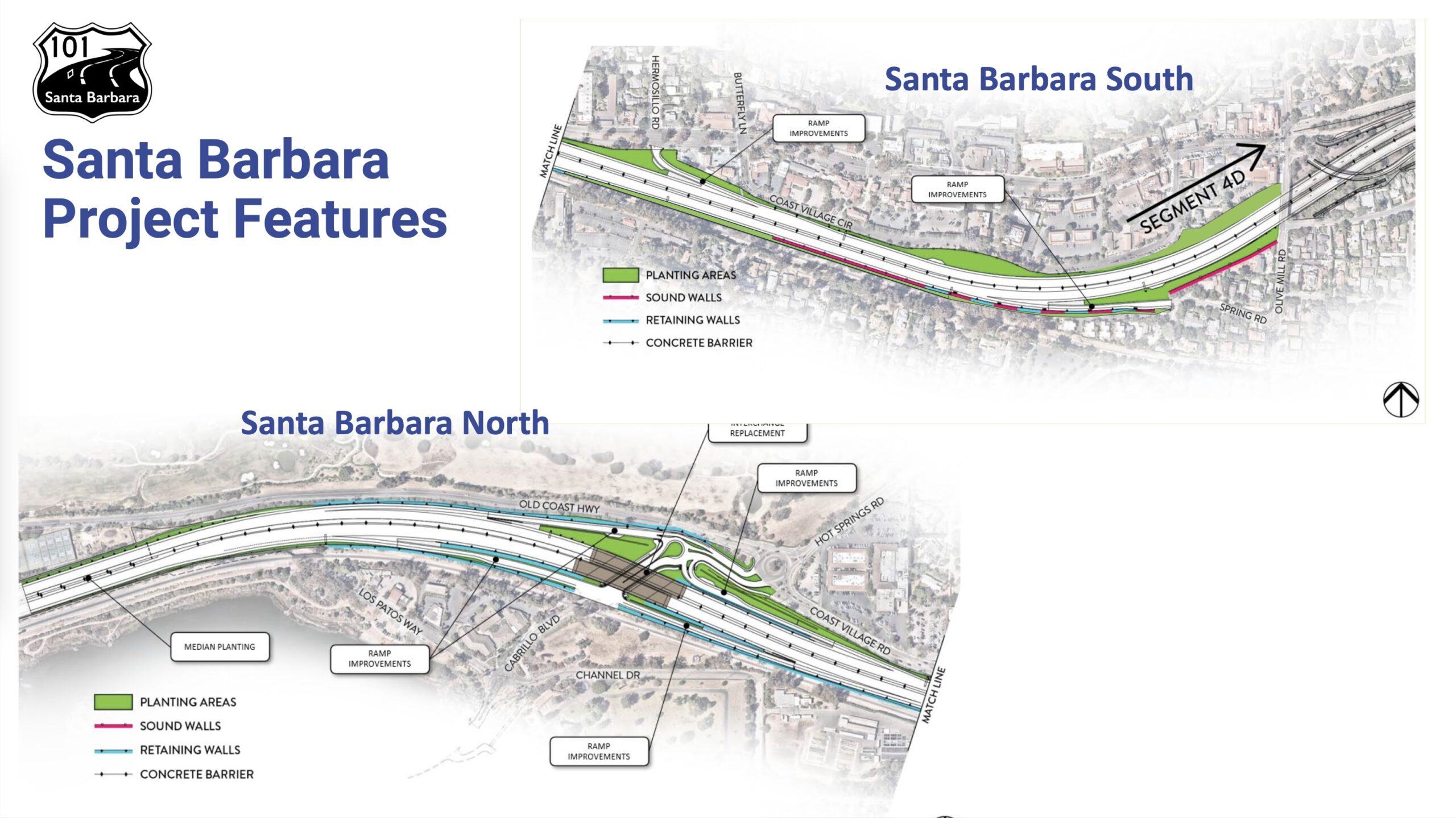

SBCAG and Caltrans made a presentation to the Santa Barbara city council this week, with slides that illuminate the situation. The project is broken into two parts, Santa Barbara South (Olive Mill to Hermosillo) and Santa Barbara North (Hermosillo to past Salinas).

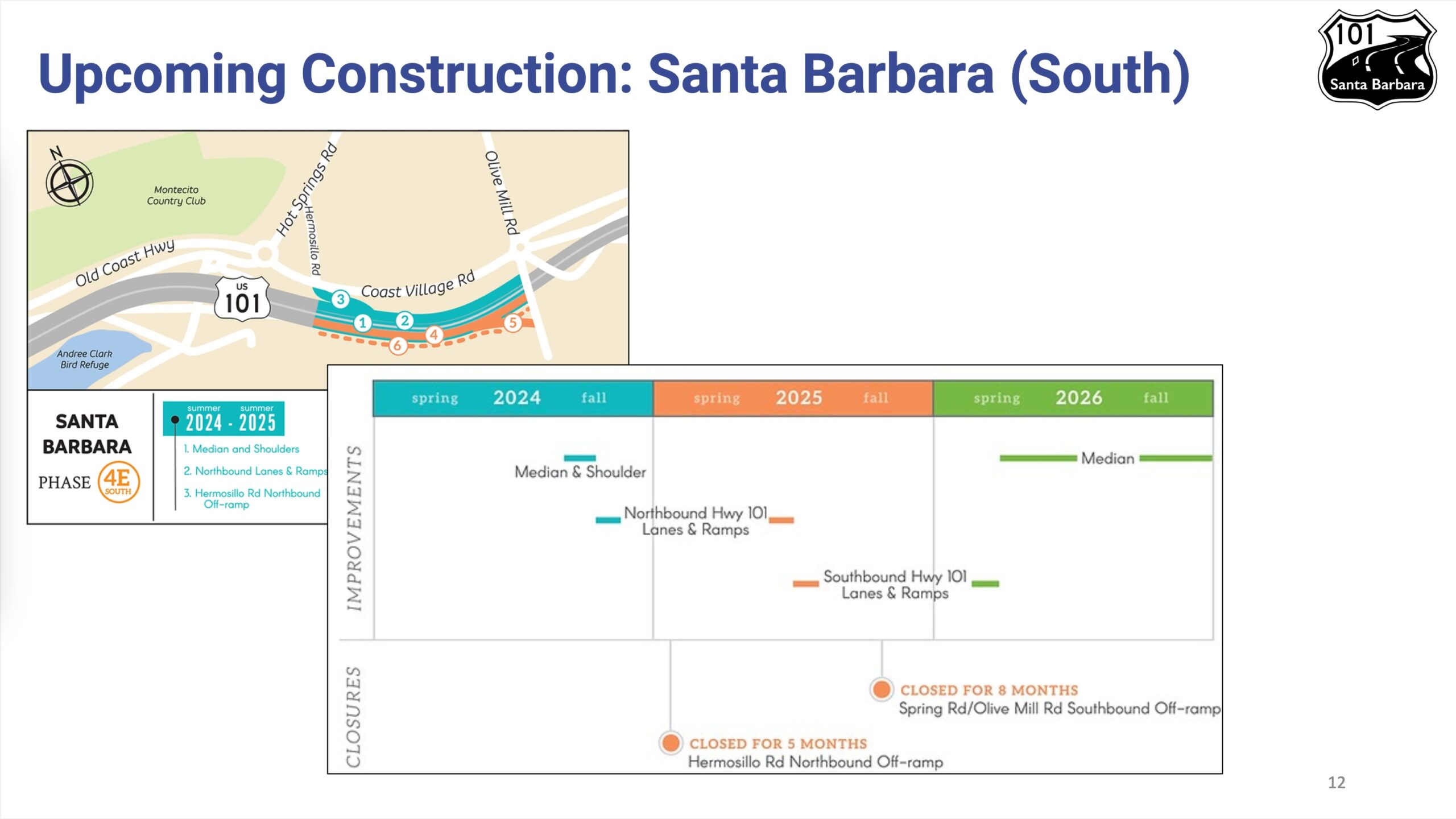

As recently noted, work is already starting on Santa Barbara South shoulders and median. Starting early next year, the northbound Hermosillo off-ramp will be closed for five months, and later in 2025, the southbound off-ramp at Olive Mill will be closed for eight months.

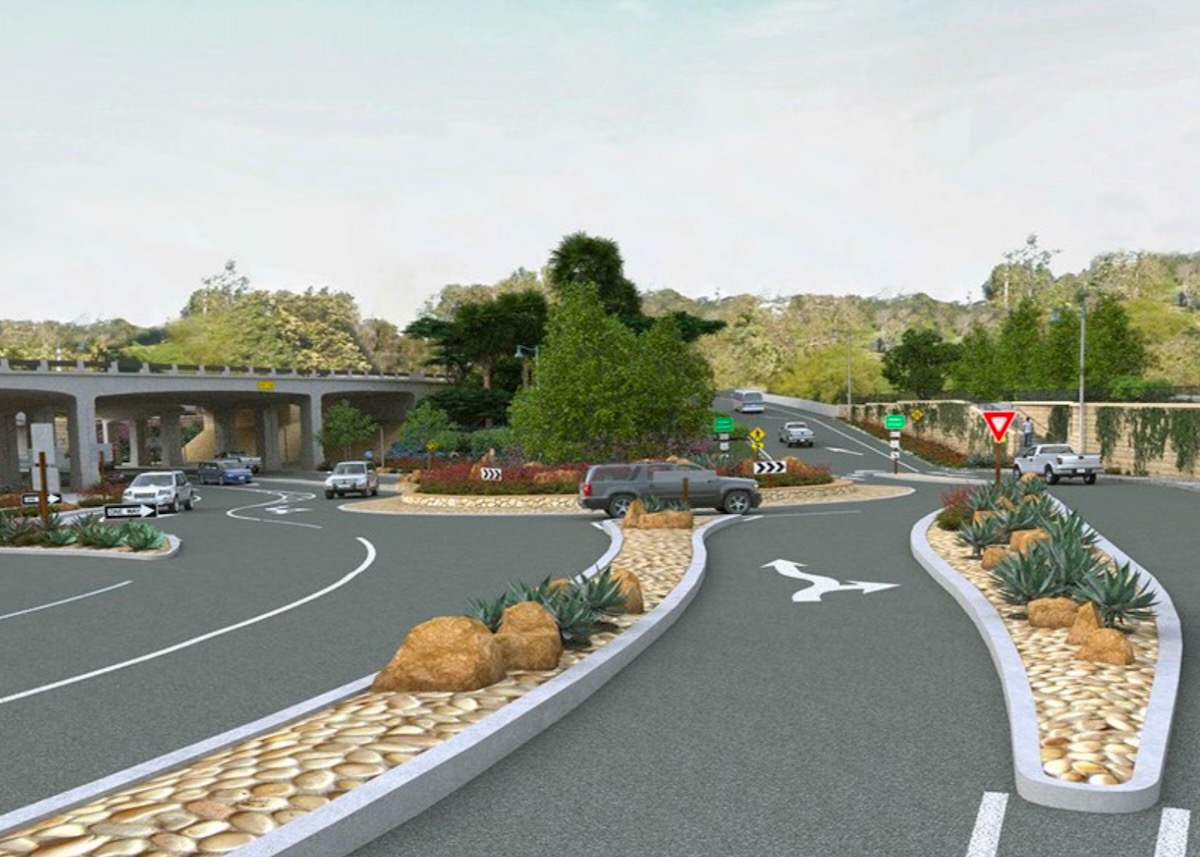

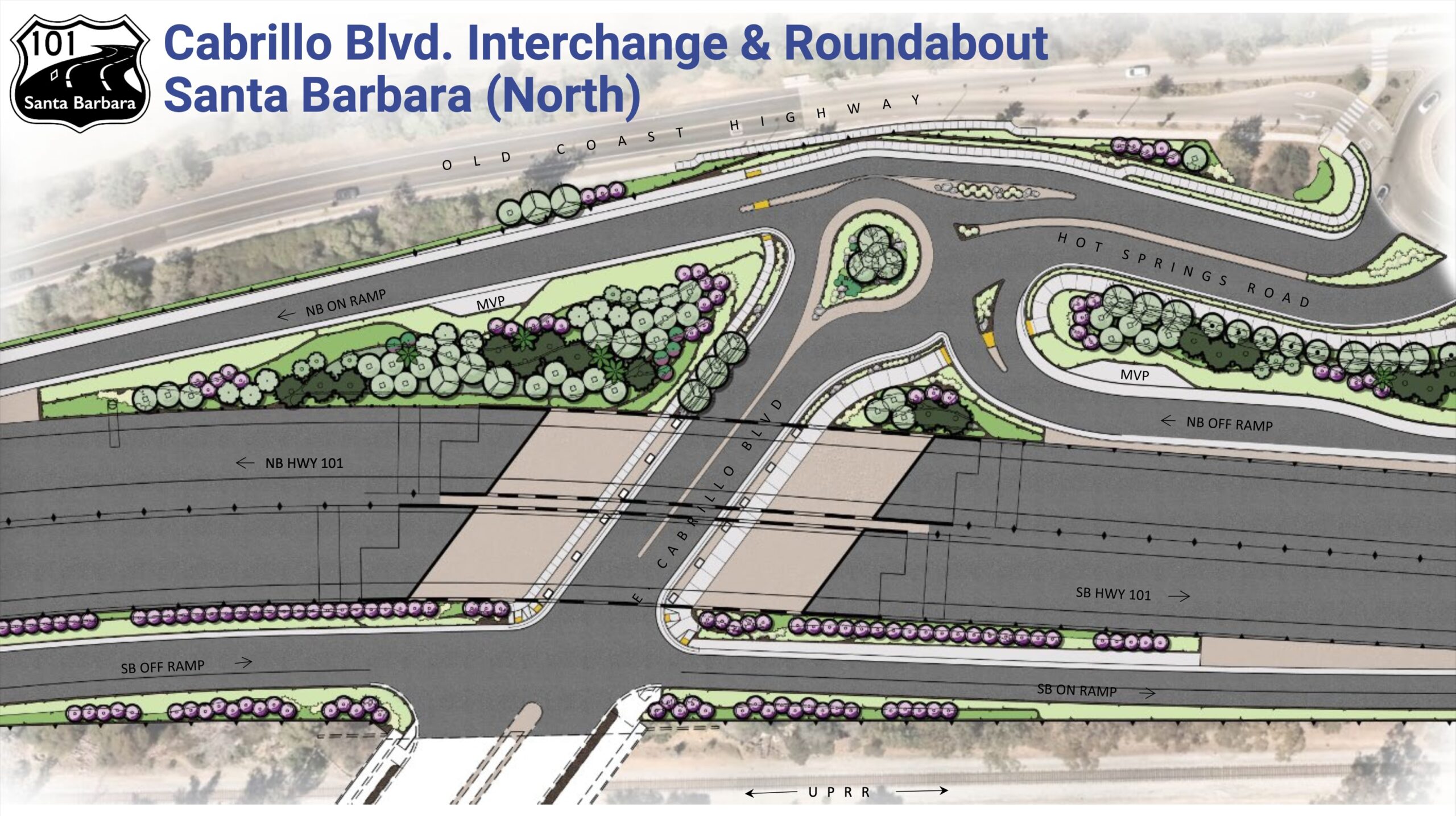

The big beast is the Cabrillo/Hot Springs interchange, where a new bridge will have lanes pushed together (instead of separated) and on- and off-ramps in both directions (and no more left exits).

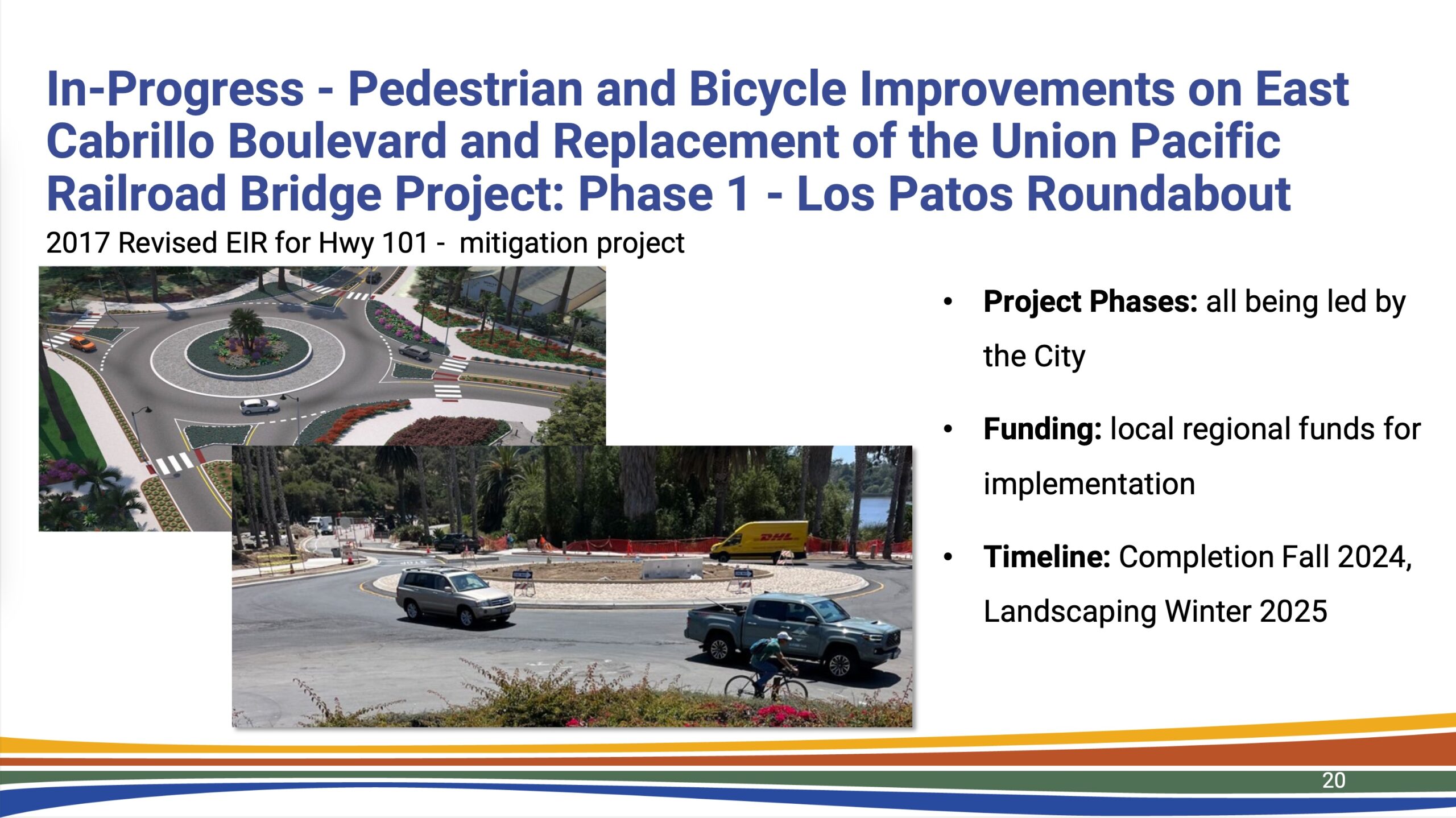

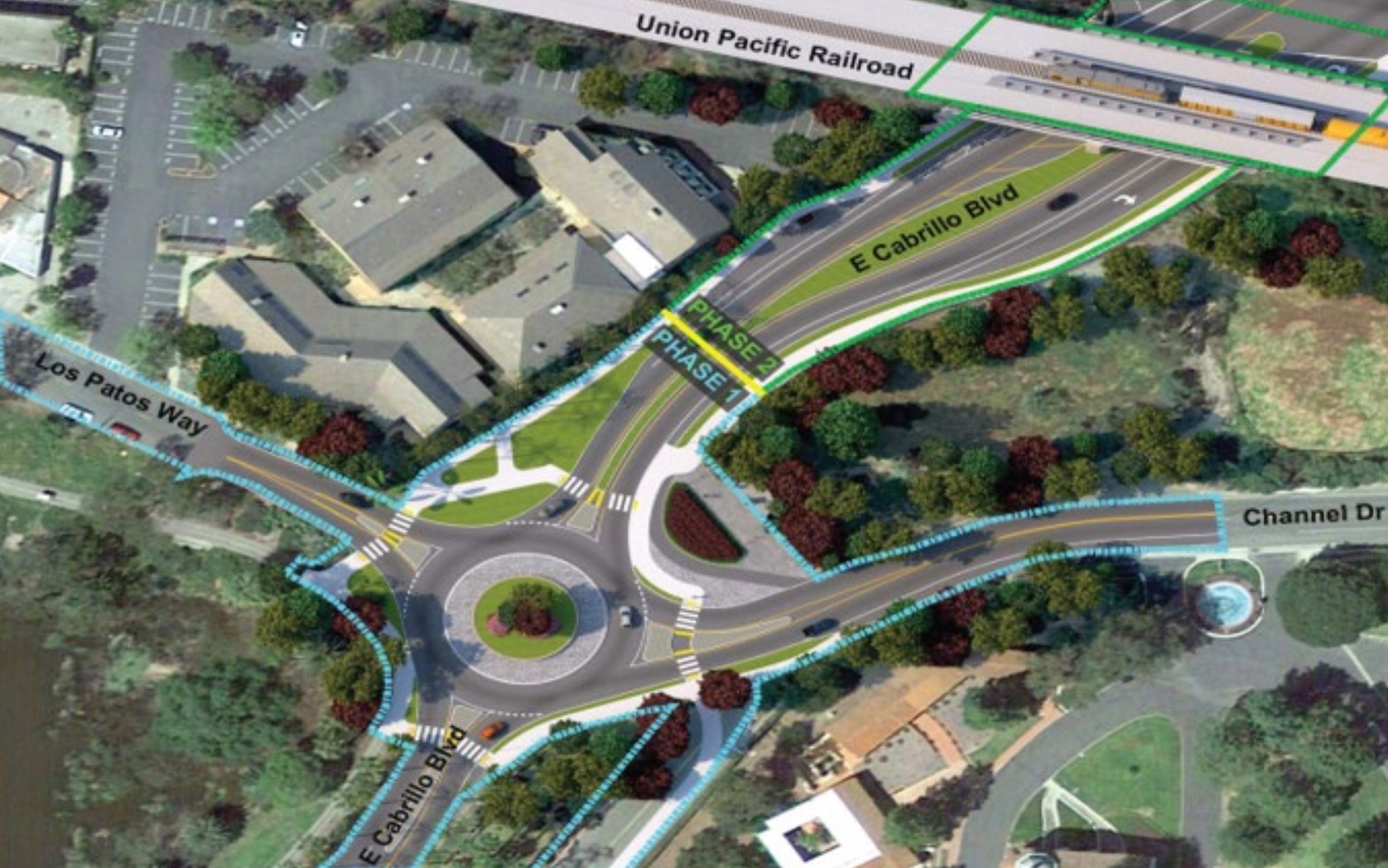

Between Hot Springs and the beach, there will be three roundabouts in a row: the current one at Coast Village Road/Old Coast Highway, the new one at the interchange described above, and the one under construction at Los Patos Way. The latter is progressing nicely and should be done in coming months.

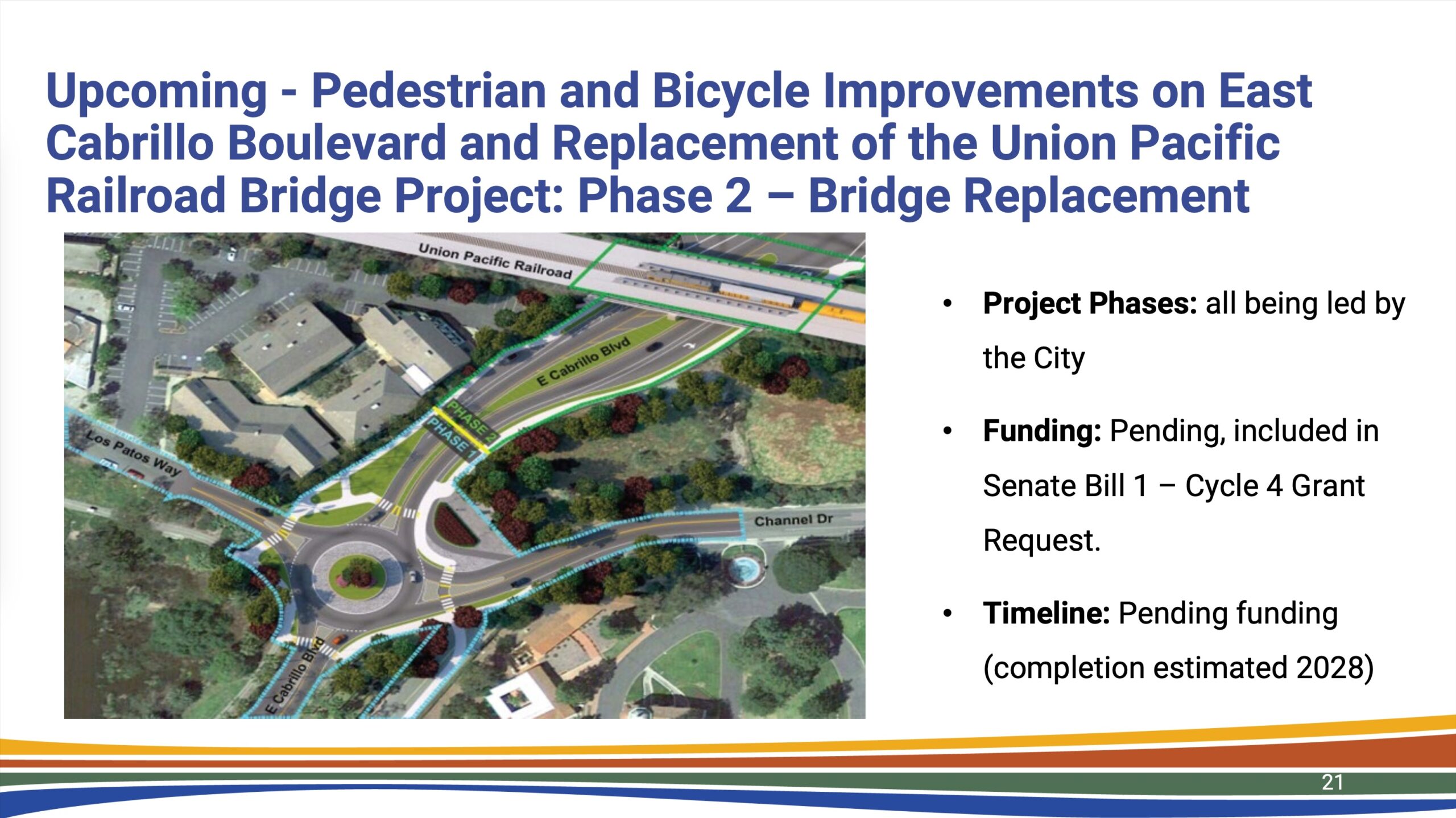

The railroad bridge component awaits funding, but when it’s done, Cabrillo Boulevard will be widened to accommodate a median, with turn lanes and a bike lane (er, multipurpose path) that hugs the cemetery below the roundabout. SBCAG and Caltrans have been very forthcoming with the public about timelines and impacts. If you don’t already receive the email updates, you can sign up at SBRoads.com.
